Home /

REAL ESTATE COLLECTIVE GROUP

Valencia Pointe

Development Study · San Diego, California

Valencia Pointe affordable housing community
102New construction homes
$50.4MTotal project cost
June 2022Construction completed

5930 Division Street, San Diego, CA 92114

THE COMMUNITY

Housing with resident support.

Valencia Pointe serves low- to moderate-income families. CRP Affordable partnered with the Metropolitan Area Advisory Committee on Anti-Poverty of San Diego County (MAAC) to provide resident services that promote health, wellness, and self-sufficiency.

MAAC programs address barriers to housing stability and help individuals and families identify housing opportunities.

Resident services
  • STEP Centers (Striving Towards Economic Prosperity)
  • DUI Education Program
  • Head Start, Early Head Start & State Preschool
  • Senior inter-generational program
  • Food bank partnership

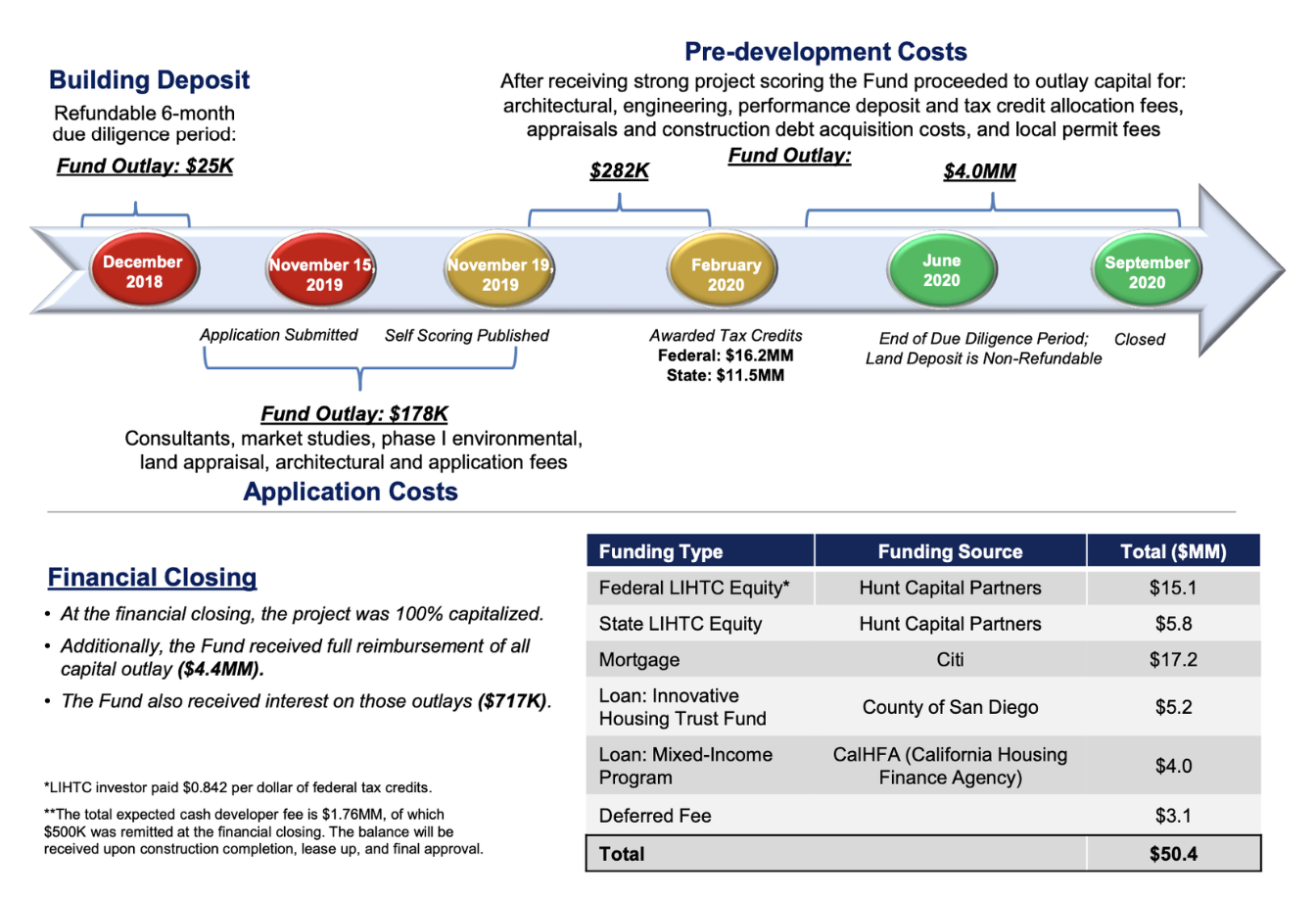

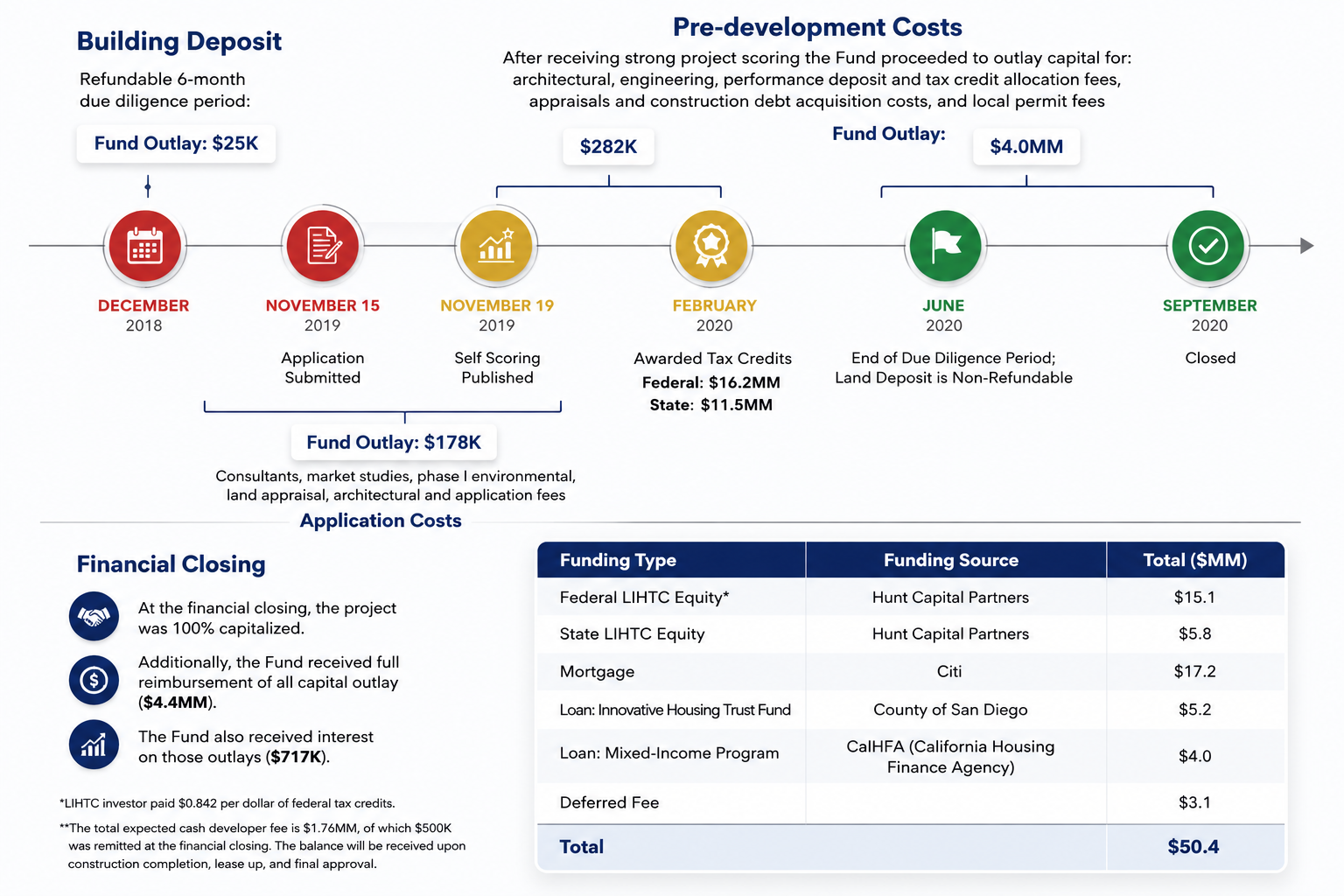

FROM ACQUISITION TO COMPLETION

The development timeline.

Land acquisition: December 2018. Financing closed in September 2020 with Citi Community Capital, Hunt Capital Partners, Monarch Private Capital, and the County of San Diego. Construction was completed in June 2022.

Valencia Pointe — development timeline

DateMilestone
December 2018Building deposit. Refundable 6-month due diligence period. Fund outlay: $25K.
November 15, 2019Application submitted.
November 19, 2019Self scoring published.
February 2020Awarded tax credits: Federal $16.2MM; State $11.5MM.
June 2020End of due diligence period; land deposit is non-refundable.
September 2020Closed.

PROJECT FINANCING

How the project was funded.

Funding at closing

Funding typeFunding sourceTotal ($MM)
Federal LIHTC equity*Hunt Capital Partners$15.1
State LIHTC equityHunt Capital Partners$5.8
MortgageCiti$17.2
Loan: Innovative Housing Trust FundCounty of San Diego$5.2
Loan: Mixed-Income ProgramCalHFA (California Housing Finance Agency)$4.0
Deferred fee—$3.1
Total$50.4
Development costs & closing details

Application costs

Fund outlay: $178K. Consultants, market studies, phase I environmental, land appraisal, architectural and application fees.

Pre-development costs

After receiving strong project scoring, the Fund proceeded to outlay capital for architectural, engineering, performance deposit and tax credit allocation fees, appraisals and construction debt acquisition costs, and local permit fees.

Fund outlays shown in the timeline: $282K and $4.0MM.

Financial closing

At the financial closing, the project was 100% capitalized. The Fund received full reimbursement of all capital outlay ($4.4MM) and interest on those outlays ($717K).

* LIHTC exchanger paid $0.842 per dollar of federal tax credits.

The total expected cash developer fee is $1.76MM, of which $500K was remitted at the financial closing. The balance will be received upon construction completion, lease up, and final approval.
